Greenville, NC
Home MenuPavement Management Program

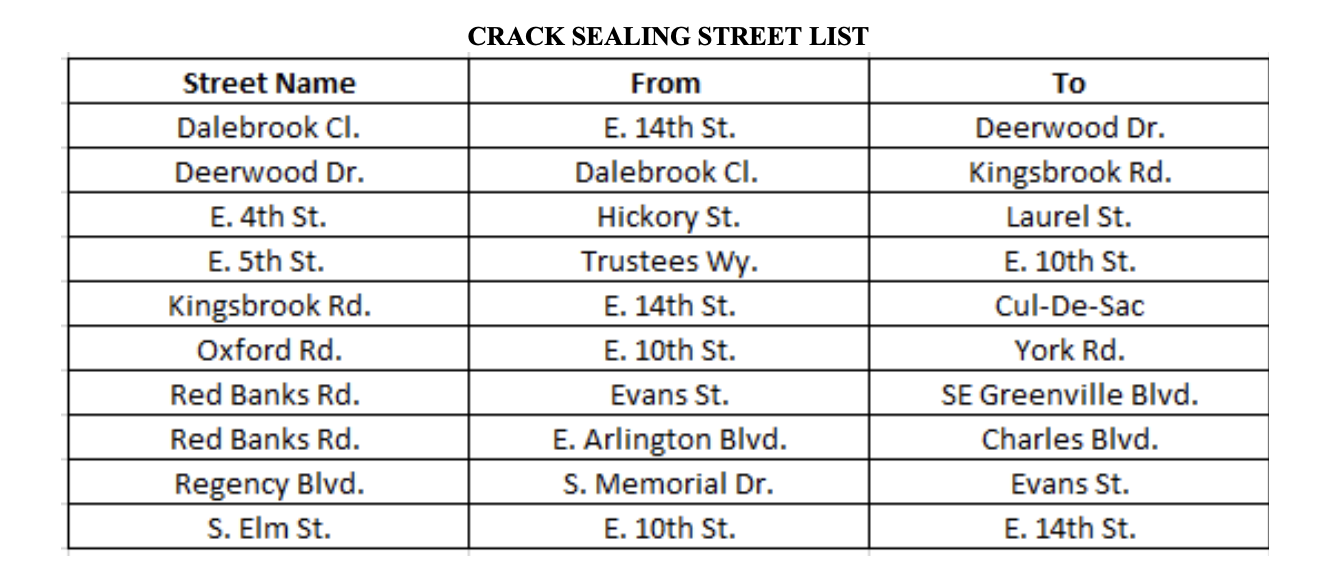

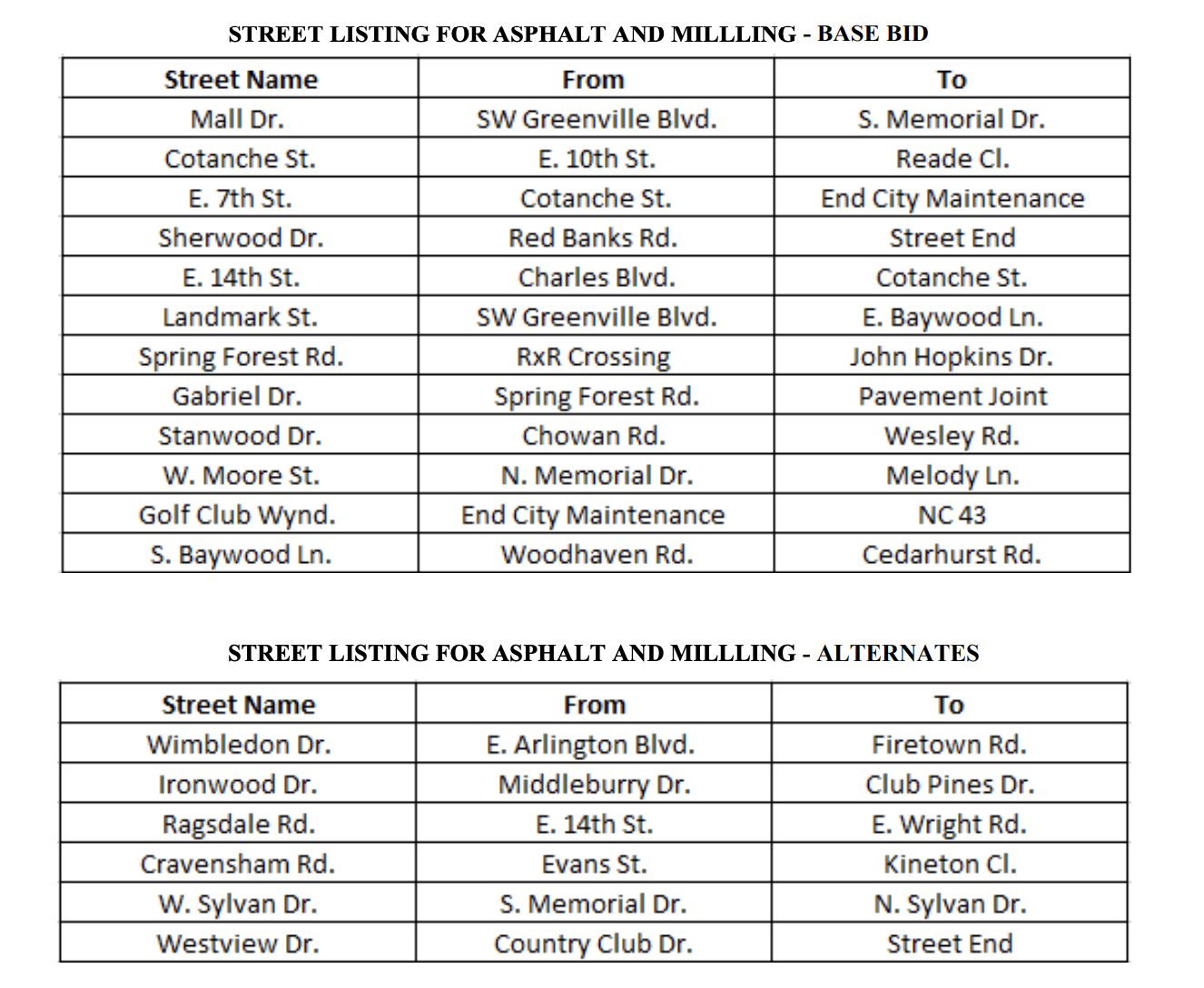

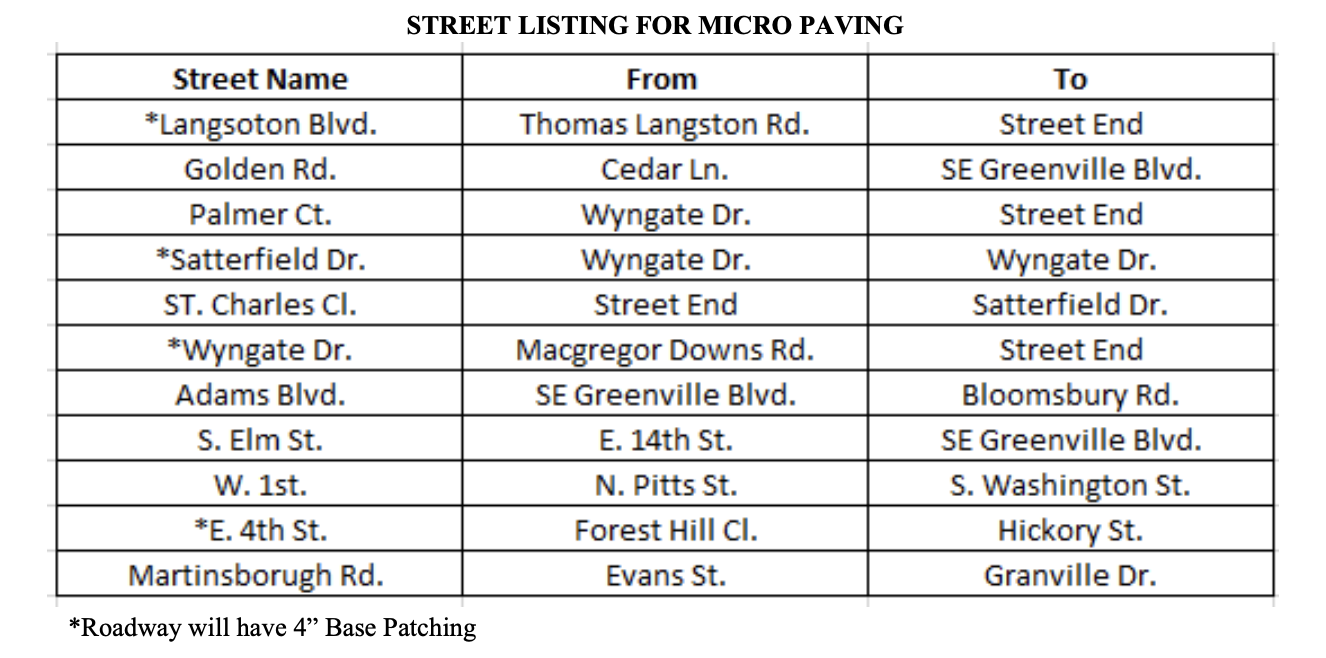

The City of Greenville's 2024 Street Rehabilitation and Preservation Project began in March 2024. The 2024 project includes new asphalt and milling on 27 City streets, with preservation efforts (including crack sealing, rejuvenator, micro-surfacing, and cape seal) on 51 others. Streets that are included in this year's project are listed below.
All streets are selected for rehabilitation or preservation using some or all of the following information:
- Roadway conditions analysis (performed in 2019)
- Public Works maintenance records and sample road cores
- Utility coordination
- Suitability for resurfacing
- Road classification - major or minor roadway
Since 2013, the City has resurfaced nearly 375 lane miles at a cost of more than $23 million.
